What we do

Every number shows where it came from.

A price you can’t check is just an opinion. The bank, the insurer, your client — they all have to believe it, and none of them can ask the builder how he got there. The document has to answer that by itself.

Here is a real one, taken apart. It prices a full renovation of an 80 m² apartment in Amsterdam.

Groepslijn

Work is grouped by trade, and each group totals on its own. The chapter numbers follow the STABU structure, so anyone who works with bestekken can navigate it on sight.

Groepslijn 24 RUWBOUWTIMMERWERK met totaal 28.632,12

Elementenlijn

Inside the group, one line per item of work — how much, at what rate, and what it comes to. Labour sits apart from materials, so you can see which half of the price is men on site and which half is stuff being delivered.

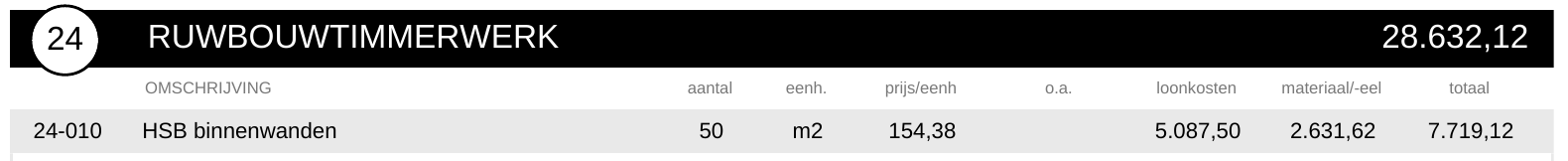

Groepslijn 24 RUWBOUWTIMMERWERK met daaronder elementenlijn 24-010 HSB binnenwanden, 50 m2, loonkosten 5.087,50, materiaal 2.631,62, totaal 7.719,12

Calculatielijnen

Under the element sit the parts it is built from. They carry their own quantities — the plasterboard is 200 m² against the wall’s 50, because it is both sides, twice over. No separate price: the element line is their sum.

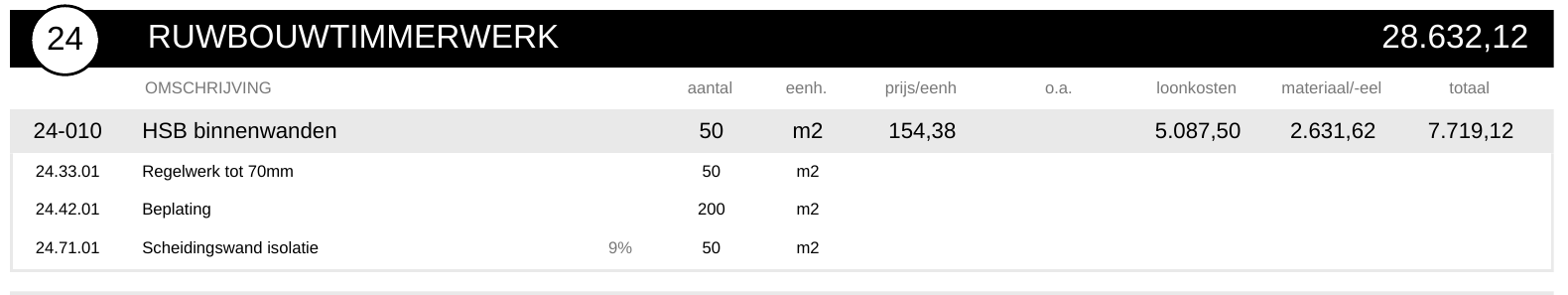

Elementenlijn 24-010 HSB binnenwanden met de calculatielijnen: regelwerk 50 m2, beplating 200 m2, scheidingswand isolatie 50 m2

Inbegrepen en niet inbegrepen

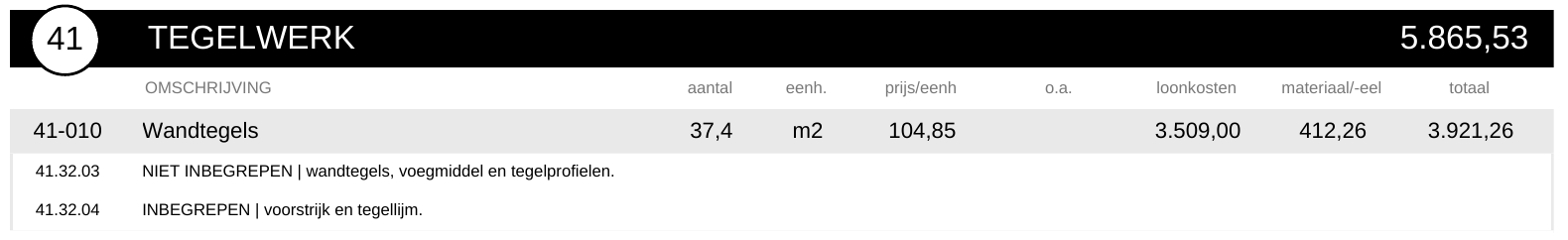

On another line — the tiling — what the price covers is stated on the line itself, not in small print at the back. The tiles are not in it. The adhesive is.

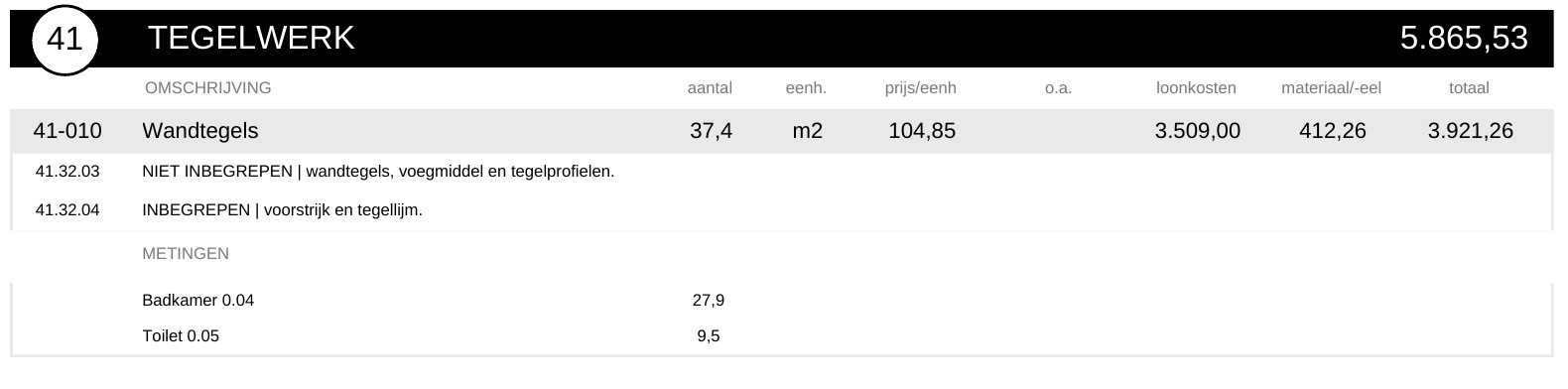

Groepslijn 41 TEGELWERK met elementenlijn 41-010 Wandtegels en de regels NIET INBEGREPEN en INBEGREPEN

Metingen

Carried further down the same line: where the quantity came from, room by room. Badkamer 27,9 plus toilet 9,5 makes the 37,4 m² above — check it against your own plan.

Dezelfde elementenlijn 41-010 Wandtegels met de metingen: badkamer 27,9 en toilet 9,5, samen 37,4 m2

Aankoop

On the doors, again elsewhere in the document: where a material is bought in, the assumed price is on the page. Choose something dearer or cheaper and you can see exactly which number moves.

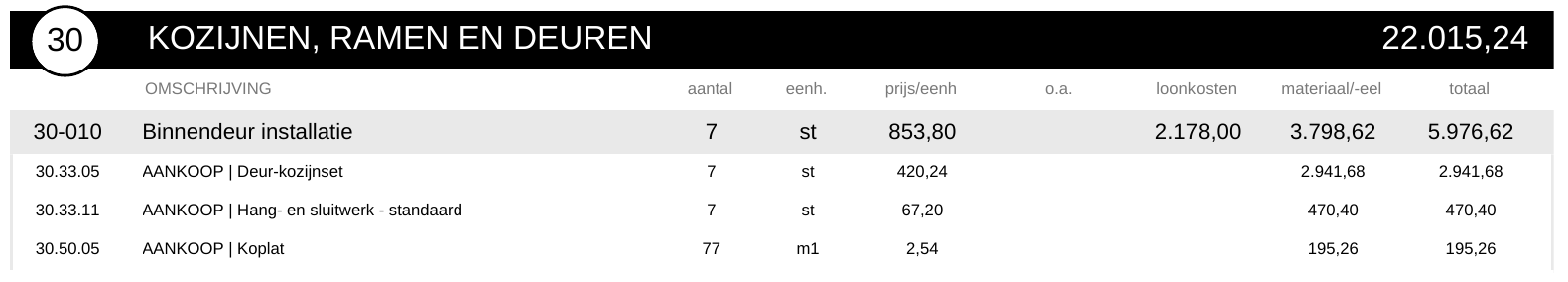

Elementenlijn 30-010 Binnendeur installatie met aankoopregels voor deur-kozijnset, hang- en sluitwerk en koplat

Stelpost

Some things cannot be priced exactly yet — here the skips. Those carry a budget figure, marked as one, and settle against what is actually spent. The line underneath says plainly what it does not cover.

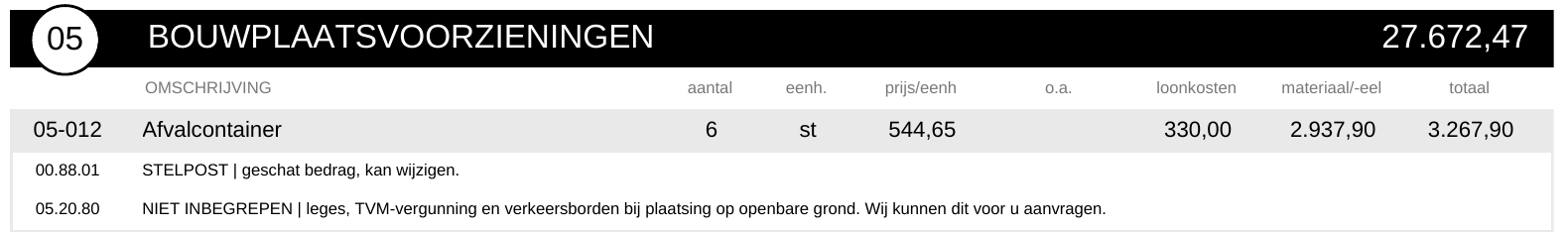

Elementenlijn 05-012 Afvalcontainer met stelpost: geschat bedrag, kan wijzigen, en de regel NIET INBEGREPEN

Optie en bevroren

An optie is priced but deliberately left out of the total, so the headline number never includes work you didn’t ask for. A bevroren line carries no price at all — considered, and not calculated. Both stay visible in grey, so you can see what was thought about.

Grijze optieregel 60-300 Vloerverwarmingregeling, niet opgenomen in de totale prijsraming Bevroren regel 42-030 Egalisatiekorrels aanbrengen, zonder bedrag

Eindtotaal

At the end the same split runs across the whole job: labour, materials and subcontractors apart, and both BTW rates shown.

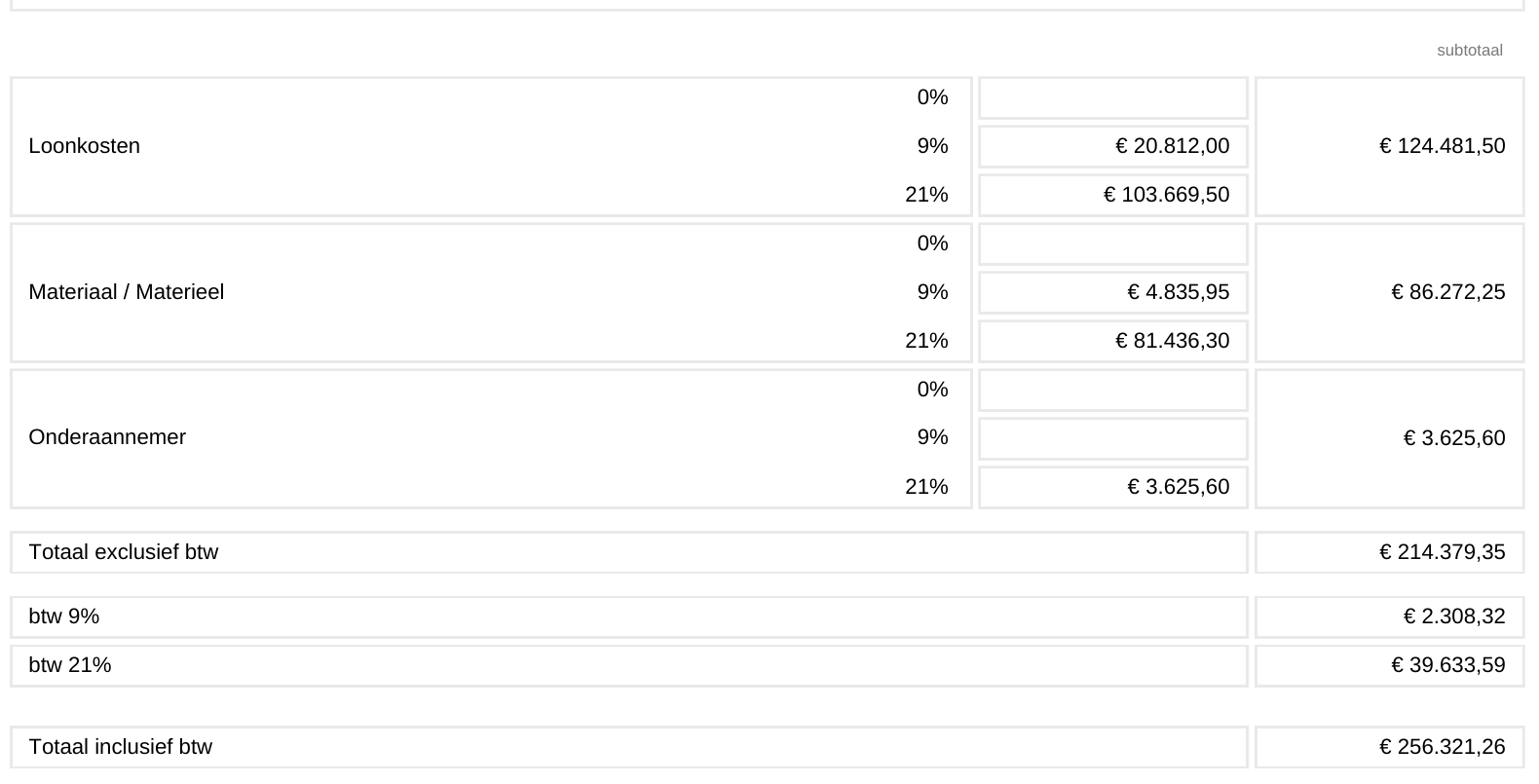

Eindtotaal: loonkosten 124.481,50, materiaal 86.272,25, onderaannemer 3.625,60, totaal inclusief btw 256.321,26

An estimate, not a quote

A kostenraming prices the work as specified. It is not a builder’s binding offer, stelposten can move, and the exclusions are real. All of it is written down in the first chapter, before any number appears — which is rather the point.

Your estimate will look like this

Same structure, same rules, your job instead of this one. If a line is ever unclear, this page explains it — or ring me.
